Archive for the 'ECOR' Category

The proposed expansion of Bhubaneswar station to 10 platforms should be implemented asap

Bhubaneswar- Cuttack- Puri, ECOR, World-class stations 9 Comments »

Thanks very much Bikash Dash for the pointer to http://wiki.iricen.gov.in/doku/lib/exe/fetch.php?media=9209%3Aabkhare.pdf. The solution presented there to expand the current Bhubaneswar station to 10 platforms is very good. Since the expansion of existing Bhubaneswar station is deemed economically feasible, they should just go ahead with that immediately (asap) and at the same time start acquiring land in the New Barang location so that a large station can come up there in 10-15 years when that will be needed.

Following are some pictures from the above mentioned slide sets.

The main hurdle with respect to the above plan is the private land that is marked as "to be acquired". That part is shown in red in the map below.

I hope that hurdle is overcome and the expansion gets going asap. If there is trouble then a simple alternative is to move the commercial part to the area marked in green (in the map below) and make the parking area marked in orange a multi-level one with the underground part going under the Janpath to the commercial complex marked in green.

Since the land marked in green is government land this would not cause a lot of trouble and as mentioned before it will connect the station complex with the IG park, Secretariate, Assembly, and Rabindra mandap. In the future there may be a Las Vegas style monorail connecting all these parts. (Note that this plan will not affect the existing coaching yard much. That money can be used in making the underground path connecting the green part and the orange part.)

But in 10-15 years the ten platforms will not be enough; especially when there will be many suburban routes with more frequent trains. Examples of such lines:

  • Bhubaneswar-Puri-Konark (Puri-Konark extension is expected)
  • Bhubaneswar-Berhampur-Gopalpur (Berhampur-Gopalpur extension is expected; post connectivity)
  • Bhubaneswar-Khurda Rd-Nayagarh (part of Khurda-Balangir line)
  • Bhubaneswar-Talcher
  • Bhubaneswar-Rajathgarh-Tangi
  • Bhubaneswar-Bhadrak
  • Bhubaneswar-Paradeep
  • Bhubaneswar-Barang-Astaranga (new port connectivity)
  • Bhubaneswar-Puri-Baliharchandi (new port connectivity)
  • Bhubaneswar-Jakhapura-Sukinda

So the alternative plan of a major station near Barang should also proceed but with a slower speed. Especially the land should be acquired asap before the prices become very high.

Bhubaneswar railway station desperately needs additional platforms

Bhubaneswar- Cuttack- Puri, ECOR, Railways, World-class stations 6 Comments »

Update: Thanks very much Bikash Dash for the pointer to http://wiki.iricen.gov.in/doku/lib/exe/fetch.php?media=9209%3Aabkhare.pdf. The solution presented there is good enough. My only comment would be that since the expansion of existing Bhubaneswar station is economically feasible, they should just go ahead with that immediately (asap) and at the same time start acquiring land in the New Barang location so that a large station can come up there in 10-15 years when that will be needed.

The Bhubaneswar railway station currently has only FOUR platforms. That is too little for the volume of trains and passengers it caters to and will cater to in the future. Besides being on the main Howrah-Chennai line and the ECOR headquarter, with the Bhubaneswar metro area growing and many new lines in the anvil (Khurda-Balangir, possible new line to Astarang to serve the proposed port there, Khurda Rd To Rajahthagarh completing a circuit)  there will soon  be need for many local train circuits with more frequent trains.

All this means that even if a new station near Barang (15-16 kms from Bhubaneswar) is constructed with enough platforms, because of the central location of the Bhubaneswar station, the later needs to be expanded with additional platforms.

But there is no horizontal available land in parallel to the exisiting platforms.

I envision two possible solutions:

(i) Going vertical and creating another layer of platforms either under or above the existing platforms. But that would add may be another 4 platforms.

(ii) Another possibility is to go under and create a terminus under the area marked in blue in the pictures below. All those land is owned by the Odisha government. So land acquisition is not a problem.

As can be seen from the pictures above one can add 8+ more platforms perpendicular to the existing 4 platforms. All this can be done in a PPP mode with making good use of shopping, pedestrian plaza and surface transport center all in the ground level and higher and stretching all the way up to the Indira Gandhi park and the Assembly Hall, Secretariat, Rabindra Mandap etc.

The new platforms could mostly be used for trains origniating and terminating at Bhubaneswar; thus  not hampering the stopping times of thorough trains which would  need an engine direction change if they go to the new platforms.

Work starts on Paradeep-Choudwar-Rourkela Industrial Corridor

Angul, Anugul- Talcher - Saranga- Nalconagar, Bhubaneswar- Cuttack- Puri, Bhubaneswar-Dhenkanal- Anugul, CKP ... Bhalulata - Rourkela - Jharsuguda Jn - Daghora , Cuttack, Cuttack - Paradeep, Cuttack-Paradip, Dhenkanal, IDCO, Jajpur, Jharsuguda-Sambalpur- Bargarh, Jharsugurha, Jharsugurha- Brajarajnagar- Belpahar, Kendrapada, Khordha, Paradeep port, Paradip - Jatadhari - Kujanga, Rourkela- Kansbahal, Rourkela-Jharsuguda, Sambalpur, Sambalpur - Talcher, Sambalpur-Burla-Jharsuguda, Sambaplur- Burla- Bargarh- Chipilima, Sundergarh, Talcher - Barang, Talcher - Bimlagarh (under constr.) 1 Comment »

Following is an excerpt from a report in ibnlive.com.

The state government has started work on development of a railway corridor through Choudwar to Rourkela to allow ease of inward and outward transportation of goods from the industrial hubs and mining belts along the region.

Land acquisition for the project, the first of its kind initiative by a state government, has already been initiated by the Industrial Infrastructure Development Corporation (Idco). The project would go on ground after the land acquisition and is targeted to be completed by 2015, said Idco CMD Priyabrata Patnaik on Friday.

The corridor involves development of extensive rail and road connectivity, along with provisioning of water supply and other infrastructural facilities. The corridor would encompass two track railway lines and six-lane road passing through the industrial hubs and the coal mining belts. New industrial areas and downstream units would be developed along the corridor.

Common infrastructure facilities under the corridor would solve the problems of inward and outward transportation of goods and minerals. The stretch would pass through the heart of coal mining operations in the state, which harbours about 65 billion tonne of reserves. The coal reserves in the Talcher belt only is around 43 billion tonne.

The corridor would cover 17 large and mega-industries, along with 57 other units, through the stretch from Choudwar to Rourkela. Traffic projection on the route is given out as 8.7 million tonne.

The route would have 163 km of railway track length and 465 km on road. As many as 308 minor bridges and 77 major bridges would have to be constructed on it, said Patnaik.

Note 1: The 163 km of railway track probably refers to the Talcher-Bimlagarh segment.

Note 2: Although the above report only mentions the Choudwar-Rourkela part, in earlier documents there is mention of Paradeep-Choudwar-Rourkela industrial corridor. See for example this 2009 Business Standard report. Following are some excerpts from that.

The Orissa government plans to develop an industrial corridor running from Paradeep to Rourkela through industrial hubs like Choudwar, Talcher and Sambalpur.

Though the initial proposal was to have an industrial corridor originating from Choudwar to Rourkela, the proposal was modified to extend the corridor till Paradeep to allow inward and outward transport of goods through the Paradeep port, sources said.

… The proposed industrial corridor will be in line with the Delhi-Mumbai Industrial Corridor and is designed to pass through national highway no.42 and national highway no 5 (A).

Under the project, both road and rail corridor will be developed, which will be the backbone of the proposed project. The industrial estates and down stream units would be developed over 25 km area on both sides of the corridor.

IL&FS has been appointed as the consultant for the project and it has already submitted the pre-feasibility study report to the industry department on the project. However, the detail cost of the project is yet to be worked out yet, sources added.

The latest initiative of the state government follows a similar initiative to develop a common ‘rail-road-water pipeline and infrastructure corridor’ in Meramundali-Angul-Talcher-Chhendipada belt, to facilitate movement of coal in the Talcher coalfield area.

The project is estimated to cost about Rs 5000 crore including Rs 2000 crore for 2-line rail corridor and Rs 1100 crore for 4 lane road alongside it. The land width of the proposed corridor will be 300 metre which includes 60 metre for road and 20 metre for water pipeline.

The total length of the corridor is 137 kilometre which includes length of 43 number of major bridges to be constructed on this stretch. RITES Ltd has already submitted a pre-feasibility report to the state owned Industrial Infrastructure Development Corporation of Orissa Ltd. (Idco) on the project.

The project is designed to have multi-point centralised loading stations conceived along the corridor rather than individual bulb connections with a view to avoid interference or wastage of coal bearing areas. Road and water pipe alignment will run parallel to rail alignment, sources said.

It will be connected to rail line at three locations- Jharpada, Angul and Budhapanka. The common corridor will have multiple entry and exit points and no surface crossing. Besides, flyovers are proposed to avoid cross movements at junction stations.

This ‘rail-road-water pipeline and infrastructure corridor’ in Meramundali-Angul-Talcher-Chhendipada belt is projected to handle 113 million tonne coal by 2014-15. It includes 55 million tonne coal movement required by the power companies, 40.76 million tonne by steel companies and 17.22 million tonne by other industries.

Infrastructure hurdles getting noticed; Some Odisha projects in focus

Aluminium, Anil Agarwal, Bauxite, Business Standard, CENTER & ODISHA, Haridaspur - Paradeep (under constr.), Kalahandi, Talcher - Bimlagarh (under constr.), Vedanta 6 Comments »

In the following excerpts from a report in Business Standard Haridaspur-Paradip and Talcher-Bimlagarh are listed as strategic projects. I hope they are fast tracked.

… Delays in land acquisition and forest clearances continue to stand in the way of completing strategic projects like the 82-km Haridaspur-Paradip line and the 154-km link between Talcher and Bimlagarh, both in Orissa. While the first project is to give good port access to units in the steel hub of Kalinganagar, the second is designed to step up evacuation of coal from mines at Angul and Talcher.

…This is why India, endowed with the world’s fifth largest bauxite deposits and the fourth largest coal reserves, has emerged as a preferred place for making aluminium. Within the country, Orissa is where every aluminium maker wants a presence. That is why the Vedanta group, in spite of being solidly anchored in Chhattisgarh, thanks to its 50 per cent ownership of Balco, with capacity of 345,000 tonnes and then giving shape to a 650,000-tonne smelter there, wants to create alumina capacity of five mt and smelting capacity of 1.6 mt in Orissa, with adequate upstream integration in bauxite mining and coal-based power.

NAY SAYERS
Unfortunately, Vedanta is not able to realise what it has set out to do in Orissa, as it fell foul of pressure groups such as Amnesty International and Survival International and also of the ministry of environment and forests. The Niyamgiri Hills, from where Vedanta’s refinery is to draw bauxite, is considered sacred by Dongria Kondh tribesmen. But why should the company be stopped to take out bauxite from there if it is ready to resettle the displaced people and practise environment-friendly mining?

As a result of the impasse, Vedanta is required to source bauxite from outside, totally upsetting the considerations for hosting a refinery at nearby Lanjigarh. The denial of mining at Niyamgiri is setting a bad precedent for the mining sector. Redemption for Vedanta would hopefully come, with the Orissa government committed to offering alternative bauxite deposits.

There are some recent news on Vedanta’s expansion in Lanjigarh. But the news are confusing. Following is an excerpt from a September 17th report in Times of India.

Vedanta has suffered another setback in its fight-back to expand the aluminium refinery in Orissa after the Union environment ministry had struck down its environment clearance for violations.

The Cuttack bench of the Orissa High Court backed the environment ministry and ordered that Vedanta would have to apply afresh for a clearance for expansion if it wants to.

Following is an excerpt from a September 19th report in ndtv.com.

The ministry of environment and forests has cleared Vedanta Aluminium’s project in Lanjigarh, Orissa.

The expansion of Anil Agarwal-led Vedanta Aluminium’s four million tonne Lanjigarh refinery plant in Kalahandi had been put on hold by the Union Environment Ministry  on October 21, 2010.

… Environment ministry’s expert appraisal committee (EAC) has cleared the project with 70 conditions, sources told NDTV. Major conditions among them are:  Five per cent of the total project cost would be spent on social welfare projects.The company will maintain air, water quality & develop 164 hectare of plant area as green belt.

Others conditions say that the company will also submit rehabilitation and resettlement policy covering tribals, which should be in line with government policies. The company will also be required to submit corporate environment policy approved by its board.

ECOR updates on various project in Odisha and the land-acqusition related stumbling blocks

Angul - Talcher - Sukinda (under constr.), Haridaspur - Paradeep (under constr.), Khurda Rd - Balangir (under constr.), Lanjigarh Rd - Junagarh 1 Comment »

Following is from a report in Telegraph:

  1. Khurda – Balangir line: "… the process of separating the government land has been hampered because of the demand of premium for it by the concerned tehsildars. This, when the state government had exempted it.

    Between the 32km and the 112km marks of the line, 1,020 acres are required and out of this, 802 acres have been handed over by the state government.

    However, processing of papers for the land acquisition from the 80km to the 112km mark is held up for verification. This patch of land is crucial for the project."

  2. Haridaspur-Paradip broad gauge line: " the progress of land acquisition has been hampered by the demand for higher compensation against acquired land by the local people. Interestingly, payment of ex gratia to the landlosers has already been made by Haridaspur- Paradip Rail Corporation Limited."
  3. Talcher-Bimalagarh new broad gauge line: "… a total of 68.56 acres of government land and 58.865 acres of forestland is yet to be demarkated by the state government in favour of railways."
  4. Angul-Sukinda new broad gauge line:  "has also not been taken up because of the state government’s non-cooperation. The project would involve 69 villages, but formalities have been completed only for 38 villages. Preliminary estimates regarding the remaining 31 villages are pending with the commerce and transport department for sanction."
  5. Rajaathagarh-Barang doubling project: "… 11 acres were required. The total private land required for the project has been acquired and the alienation proposal is under process by the district administration."
  6. Jharsuguda-Rengal doubling rail project: "119 acres are involved. Land measuring 14.570 acres in two villages is to be handed over to railways by the state government. The acquisition of another 4.310 acres is pending with the state government’s transport and commerce department."
  7. Lanjigarh-Junagarh new broad gauge line: " work has been stalled because of non-acquisition of land. With the possession of 2.8km forestland yet to be reported by the divisional forest officer, Bhawanipatna, the construction has been held up.

58417/58418 Puri – Parlakhemundi passenger extended till Gunupur

Gajapati, Naupada - Gunupur (Gauge conversion), Rayagada Comments Off on 58417/58418 Puri – Parlakhemundi passenger extended till Gunupur

With daily trains to Bhubaneswar/Cuttack/Puri and Jamshedpur/Howrah Joda – Barbil get better connected

Bolanikhadan - Padapahar, Gua - Barajamda, Jakhapura - Daitari, Jaroli - Deojhar .. Chaibasa, Keonjhar Comments Off on With daily trains to Bhubaneswar/Cuttack/Puri and Jamshedpur/Howrah Joda – Barbil get better connected

Joda and Barbil are twin towns in Keonjhar district of Odisha; they are 8-10 kms apart. These towns are surrounded by many mines and also have many industries. With the recent extension of the train from Puri to Bansapani, which is near Joda, the twin towns now have daily trains both to/from Cuttack/Bhubaneswar/Puri as well as to/from Jamshedpur (a passenger and a Jan shatabdi) and Howrah (the Jan Shatabdi). There is also a fast passenger connecting Keonjhar to Bhubaneswar.

Land acquisition status for various railway projects; first goods train run on the Bhadrak-Dhamara line; passenger services demanded

Angul - Talcher - Sukinda (under constr.), Bhadrakh - Dhamara (port conn. planned), Haridaspur - Paradeep (under constr.), Khurda Rd - Balangir (under constr.), Talcher - Bimlagarh (under constr.) Comments Off on Land acquisition status for various railway projects; first goods train run on the Bhadrak-Dhamara line; passenger services demanded

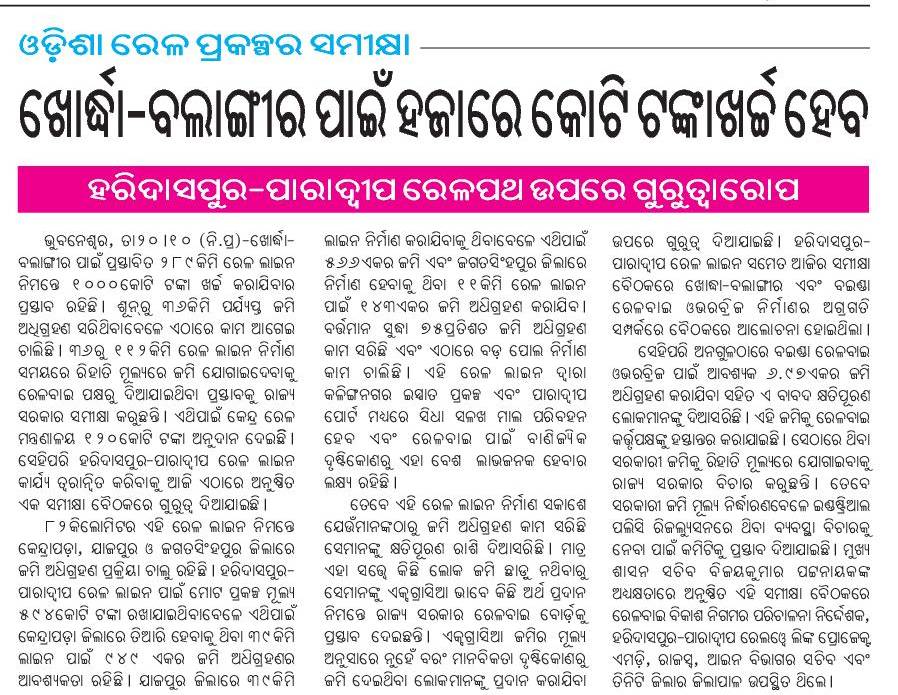

The following is from Dharitri.

The following is from Samaja.

Odisha ruling party BJD’s Railway related demands to the center

Khurda Rd - Balangir (under constr.), Odisha govt. action, Railways 2 Comments »

Following is an ad from Dharitri.

Status of doubling based on the 2011-12 railway budget

Doubling, ECOR, Railway Budget 2008, Railway Budget 2009, Railway Budget 2010, Railway Budget 2011 Comments Off on Status of doubling based on the 2011-12 railway budget

Based on the 2011-12 and 2010-11 budgets the status of doubling in Odisha is as follows:

  1. Second bridge over Mahanadi and Birupa: Done.
  2. Nergundi-Rajathgarh-Barang: Nergundi-Rajathgarh is basically done. For Rajathgarh-Barang, this year there is an allocation of 33.2 Crores. With this allocation, by March 2012, 265.2 crores is expected to be spent. This is out of a total estimated budget of 275 crores. In other words by 2012 March this part will be almost done.
  3. Nergundi-Cuttack-Raghunathpur-Rahama-Paradeep: Doubling of Nergundi-Cuttack-Raghunathpur is basically done. There is a budget of 0.1 crores for this in 2011-12 and so far 178.19 crores have been spent on this out of a total estimated budget of 180.24 crores. Doubling of Rahama-Paradeep is also basically done. There is a budget of 0.1 crores for this in 2011-12 and so far 78.72 crores have been spent on this out of a total estimated budget of 80.76 crores. There is no mention of the Raghunathpur-Rahama segment in the budget, but the maps show that this part is doubled. In other words doubling of this whole segment is done.
  4. Cuttack-Barang: This year there is an allocation of 39 crores for this. With this allocation, by March 2012, 180.2 crores is expected to be spent. This is out of a total estimated budget of 186 crores. In other words by 2012 March this will be almost done.
  5. Barang-Khurda Rd 3rd line: This year there is an allocation of 39 crores for this. With this allocation, by March 2012, 220 crores is expected to be spent. This is out of a total estimated budget of 221 crores. In other words by 2012 March this will be basically done.
  6. Khurda Rd – Delang: This year there is an allocation of 0.25 crores. It needs another 0.96 crores to complete the total estimated budget of 69.67 crores. So this is done.
  7. Delang-Puri (28.7 km): This doubling was approved in 2010-11 with a total budget of  133.71 crores and an annual allocation of 2 crores. This year it has been given a budget of 35 crores. It needs another 96.71 crores before it is completed. That would mean that it will be done around in 2-3 more years. Odisha government may use the upcoming Nabakalebar in 2015 to get this done and operational before that.
  8. Vizianagaram-Lanjigarh Rd-Titlagarh-Raipur: The maps show that Vizianagaram-Lanjigarh Rd is double line. For the Lanjigarh-Rd – Titlagarh segment, there is an allocation of 5 crores, and there is a need of another 0.8 crores tp take it to the total estimated budget of 171.4 crores. So basically the Lanjigarh-Rd – Titlagarh segment will be done by 2012 March. The 203 km Titlagarh -Raipur segment is just getting a start. The 2011-12 budget has a 60 crores allocation for this. But it needs another 629.16 crores for completion. The total estimated budget for this segment is 691.67 crores.
  9. Jharsuguda-Rengali-Sambalpur: There is an allocation of 33.5 crores in this year’s budget for the Jharsuguda-Rengali segment. After that there is only a need of 7.48 crores to take it to the total estimate of 119.54 crores. So this segment will be almost done by March 2012.  There is an allocation of 20 crores in this year’s budget for the Rengali-Sambalpur segment. After that there is only a need of 0.6 crores to take it to the total estimate of 113.55 crores. So this segment will be basically done by March 2012. Together they will be almost done by March 2012.
  10. Sambalpur-Titlagarh: This is in the initial phase. There is an allocation of 60 crores in the 2011-12 budget. By March 2011 only 39.73 crores would be spend on this. The total estimate of 950.84 crores.
  11. Rajathgarh-Talcher-Sambalpur: Maps show that the Rajathgarh-Talcher segment is double line. Doubling of Talcher-Sambalpur was approved in 2010-11 with an initial allocation of 2 crores. This year there is an allocation of 66 crores. The total budget is 613.27 crores.
  12. Bimlagarh-Champajharan-Dumetra (SER): There is a budget of 35 crores for Bimlagarh-Dumetra and another 35 crores for Champajharan-Bimlagarh. Based on the two entries in the budget, it seems the Champajharan-Dumetra part will be done by March 2012 and another 115.9 crores is need to complete the Bimlagarh-Champajharan part.
  13. Jakhapura-Daitari-Tomka-Jaruli-Bansapani (ECOR/SER): Bansapani-Jaruli is listed in the SER budget and has an allocation of 35 crores for this year. It needs another 8.18 crores to reach the estimated total of 90.89 crores. ECOR budget lists the segment Bansapani-Tomka-Daitari-Jakhapura. It was initiated in 2010-11 with a budget of 150 crores of which only 29.57 seems to have been spent. Its budget for 2011-12 is 70 crores. It needs another 843.38 crores to reach its estimated total of 942.95 crores.
  14. Bansapani-Padapahar Jn-Bara Jamda Jn-Barbil Raj kharswan-Padapahar Jn: Maps show that Rajkharswan-Padapahar Jn – Barajamda Jn is double line. The 2011-12 budget has 5 crores each for the two segments of Bansapani – Padapahar and Bara Jamda – Barbil. After that  Bansapani – Padapahar will reach its estimated total of 155.28 crores and Bara Jamda – Barbil would need 1.51 crores to reach its estimated total of 52.51 crores. So basically all these will be double lines by March 2012.

The total 2011-12 budget for doubling is 576.17 crores. See http://www.orissalinks.com/orissagrowth/archives/3272 for how this budget compares to past budgets. See http://www.orissalinks.com/orissagrowth/archives/3259 for an old projection to the future.

Odisha related ECOR and SER new lines allocations for 2011-12 and spending during 2010-11

Angul - Talcher - Sukinda (under constr.), Haridaspur - Paradeep (under constr.), Jaleshwar-Digha, Khurda Rd - Balangir (under constr.), Lanjigarh Rd - Junagarh, New Lines, Railway Budget 2010, Railway Budget 2011, Talcher - Bimlagarh (under constr.) 6 Comments »

The above can be obtained by looking at the appropriate pages of this year’s pink book and last year’s pink book. Following are images cut from both.

From 2011-12 Pink book

Following are some observations based on the above:

  1. Khurda Rd-Balangir: It seems 115.8 crores is expected to be spent on Khurda-Balangir line during March 2010-March 2011. This is close to the 120 crores that was allocated in the 2010-11 budget. So I am not sure why the budget was slashed to 60 crores. My guess is that last year they spent the money in building on the land they had already acquired. Now they need to acquire more new land to build and so until enough new land is acquired a lot of money could not be allocated for construction. The blame here lies with the railways for not anticipating in advance and not buying enough land in the previous years. The Odisha government should have also monitored this and prodded ECOR to buy enough land in advance. A bit of good news is that the budget speech explicitly mentions that Khurda Rd-Begunia will be completed this year.
  2. Talcher-Bimlagarh: Last year the allocation was 50 crores. However, it is anticipated that 99.4-37.98= 61.42 crores will be spent on this during March 2010-March 2011. For the 2011-12 the allocation is 66 crores, and the budget speech explicitly mentions that some part of this line will be completed this year.
  3. Angul – Sukinda: In 2010-11 the allocation was 22.5 crores, out of which only 12.7 crores is expected to be spent during March 2010-March 2011. For the 2011-12 the allocation is a substantial one consisting of 27 crores (RVN) plus 169.15 crores (PPP). It is not clear where the PPP money is coming from. If it is from the Odisha government or Odisha industries then railways should not take credit for it.
  4. Haridaspur – Paradeep: In 2010-11 the allocation was 101 crores, out of which 79.6 cores (=251.2-171.6 ) is expected to be spent during March 2010-March 2011. For the 2011-12 the allocation is a substantial one consisting of 10 crores (RVN) plus 169.15 crores (PPP). It is not clear where the PPP money is coming from. If it is from the Odisha government or Odisha industries then railways should not take credit for it.
  5. Daitari – Banspani: I am not sure what the deal here is. This line is supposed to be complete. I don’t know why there is a 70 crores budget for this.
  6. Lanjigarh Rd – Junagarh: This line has an allocation of 10 crores and will be completed this year. Once that is done  Ispat Express should be extended to Lanjigarh Rd or Bhawnipatna and a Bhawniaptana – Bhubaneswar express should be introduced.

Now let us move to SER.

  1. Jaleswar – Digha (41 kms): Last year 20 crores were allocated to it. But only 2 crores is expected to be spent during March 2010-March 2011. For the 2011-12 the allocation is a substantial one consisting of 150 crores. Also due to some modification in the plan the overall estimated cost has gone up from 255.11 crores to 533.63 crores. The modification includes a segment in West Bengal. It is not clear how much of the allocated 150 crores will be spent in the Odisha part and how much in the newly tagged on West Bengal part.

The overall new lines budget for 2011-12 is 733.4 crores. But if one takes out the PPP part then it is only 393 crores. And then, if the Jaleswar-Digha part is West Bengal centric and one takes 150 crores for it out then the total reduces to only 243 crores. Is Mamata Banerjee hoodwinking Odisha here?

See http://www.orissalinks.com/orissagrowth/archives/3272 for how it compares with previous years budgets. See http://www.orissalinks.com/orissagrowth/archives/4638 for a tabular listing of the new line budget over the years. See http://www.orissalinks.com/orissagrowth/archives/3202 for an old projection to the future.

Status of Khurda-Balangir Project; misinormation on last year’s spending may have harmed this year’s allocation

Khurda Rd - Balangir (under constr.), Railway Budget 2010, Railway Budget 2011 Comments Off on Status of Khurda-Balangir Project; misinormation on last year’s spending may have harmed this year’s allocation

This project was approved in 1993-1994 and since then very little progress has been made. In the 2010-11 railway budget, for the first time, there was a decent allocation of 120 crores towards this project.

Before the 2011-12 railway budget there were a lot of news that out of the allocated 120 crores 100 crores was returned due to non-utilization.

This seems to be a false news.

If one looks at the Pink Book at http://www.indianrailways.gov.in/view_section.jsp?lang=0&id=0,1,304,366,539,1056 one can note that by the end of the 2010-11 outlay this project would have spent 211.65 crores. (See below. There seems to be some typo on the total amount needed for the project.)

In last year’s Pink Book  that number till the end of 2009-10 outlay was 105.8 crores. (See above.) In other words between 2010 March and 2011 March 221.65-105.8 = 115.85 crores would be spent. This is close to the 120 crores that was allocated.

So unless I am missing something, the politicians are spreading misinformation and actually harming the cause of the Khurda Balangir line. Instead of making false claims that 100 crores was returned (and only 20 crores was spent) and blaming the state and central government, they should have stated that 115.85 of the 120 crores was spent; and now that both the state government and ECOR have shown the ability to spend almost 120 crores in the project, at least a similar amount should be allocated in this year’s budget.

Instead, for petty political gains they spread the wrong news and the aam janta who does not know the truth will think if the authorities could only spend 20 crores out of the allocated 120 crores, then its perfectly justified for the Rail budget to have only 60 crores for the project this year.

Unfortunately, we have bad politicians and many spreaders of false news and that has time and again harmed Odisha’s cause.

Having said all that, the Railway Board knew that 115.85 crores of the alloted 120 crores was going to be spent by March 2011. They should not have reduced the allocations to 60 crores for this year.

Now following are some excerpts from a report in Expressbuzz.com. It shows the misinformation being spread.

In lieu of the return of last year’s Rs.100 crore, she has sanctioned Rs.60 crore. Last year, Rs.120 crore was allocated out of which, Rs.100 crore was reportedly returned due to non-utilisation.

An earlier report, linked in a kddf posting, hopefully, gives some useful information on the land acquisition status.

… from Khurda Road to Balangir will pass through 32 bridges including the longest one over river Tel, 403 minor bridges, 11 tunnels — the longest being 1400 meters, besides 124 level crossings and 17 stations.

Land acquisition sources said land in 13 out of the 16  villages on Balangir side have been acquired. Paucity of funds has however hampered land acquisition in the remaining three villages, said Ganeswar Kanhar, Land Acquisition Officer.In 2007, compensation for 64 acres of land was given in eight villages.

Since then only six more villages could be surveyed as the proposal for land acquisition was kept pending till the first quarter of 2010. While the civil work would be taken up only after acquisition of land for the 50 km track is complete,  till now nearly 35 km is yet to be acquired. Kanhar said 36 km of civil work has been started on  Khurda side.

2011 Updating of the Status of new railway line projects in Odisha; a projection to the future

Angul - Talcher - Sukinda (under constr.), Haridaspur - Paradeep (under constr.), Khurda Rd - Balangir (under constr.), Lanjigarh Rd - Junagarh, Naupada - Gunupur (Gauge conversion), New Lines, Railway Budget 2011, Talcher - Bimlagarh (under constr.) 4 Comments »
New Lines 2006- 07 2007- 08 2008- 09
2009- 10
2010- 11 2011 -12 Spent until 2009- 10 Spent until 2010 -11 Remai ning
Total

Khurda- Balangir

(289 kms)

23 20 32.34 28.07 120 60 105.8 211.7 474.2 428.3 700 Cap

Talcher- Bimlagarh

(154 kms)

10 15 10 10 50 66 37.98 99.4 722.8 645.4 810.8 Cap

Haridas pur- Paradip

(82 kms)

44 20 80 70 101 RVN 10 RVN 169.2 PPP

21.9 Cap

171.61 RVN

21.9 Cap 251.2 RVN 299.83 RVN 541.91 RVN 5.85 PPP

21.9 Cap

572.4 RVN 803.1 RVN 175 PPP

Angul- Sukinda Rd

(98.7 kms)

20   60 75 22.5 RVN 27 RVN 169.2 PPP

20.88 Cap

13.5 RVN

20.88 Cap

26.2 RVN

581.62 RVN

389.4 RVN

5.85 PPP

20.88 Cap

617.6 RVN

442.6 RVN

175 PPP

Lanjigarh Rd – Junagarh

(56 kms)

19 12 35 30 60 10 169.31 176.6

0.69

1.5

170 cap

188.1 cap

Daitari – Bansa pani

(155 kms)

155.6   20 60 75 RVN 70 RVN

367 cap

671.85 RVN

367 cap

587.8 RVN

186.56 RVN

301.7 RVN

367 Cap

933.4 RVN

959.5 RVN

Jaleswar- Digha

(41 kms)

    Did not exist Did not exist 20 (new)  150 Did not exist  2 235.11 381.6

255.1 Cap

533.6 Cap

Buramara – Chakulia

with upgrad ation  of Rupsa – Buramara

(125 kms)

        under progress as an RVNL SPV.         466.5 RVN

Gunupur- Theruvali (79 kms)

(Naupada  – Gunupur 90 kms gauge conver  sion is now complete)

N-G 34 N-G 25

Already surveyed.

But listed as a soc. desirable project.

Odsiha should push hard for this to be designa ted as a port conn. (to Gopalpur port) project and taken up via RVN SPV.

      Odisha govt. has also indicated to push this as a PPP project.
Total allocation on new lines (NL) and gauge conver sion (GC)

Rupsa – B 15.9

Other – 4.1

Total – 325.6 crores

Rupsa – B 35

other – 5

Total – 132 crores

244.34 + 65 = 309.34 275.07+ 36.14 = 311.21

ECOR NL – 428.7

ECOR GC – 5

SER NL – 20

SER GC – 1

Total = 454.7

ECOR NL – 583.4

ECOR GC – 12

SER NL- 150

SER GC – 2

Total= 747.4

2004 – 199 crores

New Lines 2006 – 07 2007- 08 2008- 09 2009- 10 2010- 11 2011- 12 Spent until 2009 -10 Spent until 2010 – 11 Remain ing Total

ECOR earnings up; IR’s earnings down

ECOR, Railway Budget 2011, Railways 1 Comment »

Following is from a report in Pioneer.

East Coast Railway (ECoR) GM Arvind Kumar Vohra …

He informed about the achievements made by the ECoR during the last three quarters both at the freight and passenger fronts. During the period, ECoR has earned `6140.72 crore, 19.77 per cent more than the corresponding period of last year.

It has carried 79.98 MT of freight traffic, 4.91 per cent more as compared to the corresponding period of last year while 59.13 million passengers have been carried which is 12.03 per cent more than the corresponding period of last year.

The above is only about the earnings and not about profits. There is no data on that yet. However, Indian Railways as a whole has reduced earnings and may make a loss the last year. Following is from a report in Indian Express.

The Indian Railways’ great “turnaround story”, which was making waves in business schools till a few months back, now appears headed towards an ignominious end. A sharp decline in earnings and a serious escalation in expenditures are threatening to push India’s transport behemoth to near-bankruptcy.

… the Railways now has a net deficit of around Rs 2,500 crore. “While our expenditure has gone up by almost Rs 1,330 crore, our earnings are down by Rs 1,142 crore,” says a Railway Board official.

Demand for an ECOR rail division in Rourkela grows

Baripada - Bangiriposi (under constr.), Bhadrakh - Dhamara (port conn. planned), Buramara - Chakulia, CKP ... Bhalulata - Rourkela - Jharsuguda Jn - Daghora , ECOR, Jaleshwar-Digha, Rourkela - Biramitrapur, Rourkela- Kansbahal, Rupsa Jn - Baripada, Sundergarh 15 Comments »

Following is an excerpt from a report in expressbuzz.com.

How justified is the demand to carve out a separate railway division at Rourkela under the East Coast Railway (ECoR)? Given the continuing neglect towards the infrastructure and passenger amenities over decades, the demand is gaining momentum.

With apolitical and political outfits jumping on the bandwagon to seek separation of Rourkela from the Chakradharpur division of the South Eastern Railway (SER), the Railway Ministry is likely to feel the heat ahead.

Train Passenger Steering Committee convener and Rourkela Chamber of Commerce and Industry president Subrat Patnaik in tandem with the members of the Rourkela Development Forum (RDF) and Rourkela Railfanning Association (RRA) are vociferous in their demand. The local BJD unit has gone a step ahead to threaten disruption of mineral transportation by rail if the issue was not sorted out.

Locals feel, in the changed scenario, the triangular districts of Sundargarh, Jharsuguda and Keonjhar – high on industrial and mining activities – would no longer tolerate further neglect as Sundargarh alone annually contributes ` 800 crore to SER.

… Inadequate train services and infrastructure apart, the lingering of the proposed Bimlagarh-Talcher rail link is a stark pointer of neglect, they stated.

Even 10 per cent of the revenue generated from the regions is not spent to benefit a population of over 50 lakh.

RDF and RRA members Dilip Mohanty, Mahendra Mishra, Mihir Swain and Supratik Mishra sent a memorandum to the Railway Ministry over the demand claiming the combined revenue share from these three districts is anything over ` 2,200 crore.  …

The fact that there is an ECOR division in Sambalpur (147 kms from Rourkela) and Chakradharpur (101 kms from Rourkela) should not be a concern as there are many railway divisions that are much closer. In http://www.rourkelacity.com/top-news/rourkelare-rela-division/ it is mentioned that there are separate rail divisions in Varanasi and Mughalsarai that are only 17 kms apart, Guntur and Vijaywada that are 34 kms apart and so on.

The petition at http://www.petitionodisha.in/transportation/creating-a-new-east-coast-railway-division-at-rourkela/ lists various reasons why a ECOR rail division in Rourkela is needed. Please visit it and sign it.

There is also a similar need for a railway division in Rayagada or Kesinga/Lanjigarh Rd/Bhawanipatna to cater to existing lines and to the many new lines that are coming up there. The new lines include Naupada-Gunupur and its extension to Therubali and Lanjigarh Rd – Junagarh and its extension to Nabarangpur and Jeypore.  With many people in Viskhapatnam demanding that the VSKP division be split from ECOR, if that happens the Odisha part of the current VSKP division as well the above mentioned new lines should be moved to the proposed division at  Rayagada or Kesinga/Lanjigarh Rd/Bhawanipatna.

In North Odisha with several new lines coming up (Bhadrakk – Dhamara, Chakulia – Buramara, Jaleswar – Digha, ) and with the commencement of broad gauge service in the Rupsa-Baripada-Bangiriposi line a new division in Balasore or Bhadrak is warranted. SER greatly meshed up the Rupsa-Baripada-Bangiriposi line costing Indian Railways significantly. See page 8-9 of 2006-may-CAG report. These parts should also be taken away from SER.

Paralakhemundi to have broad gauge passenger train service from the 18th December 2010; Hirakhand Express extended to Jagdalpur (via Jeypore) from the same day

Gajapati, Koraput, Koraput- Jeypore- Sunabedha- Damanjodi, Naupada - Gunupur (Gauge conversion), Railway Budget 2010, Vizag ..Shimiliguda - Koraput - Dhanapur ..Kirandul 9 Comments »

Following is an excerpt from a report in Orissadiary.

217 Puri-Palasa passenger which is leaving Puri at 07.50a.m and arriving Palasa at 03.25p.m will leave Palasa at 04.30p.m and will arrive at Paralakhemundi at 06.45p.m in the extended portion. In the return direction, 218 Paralakhemundi-Puri Passenger will leave Paralakhemundi at 07.45a.m and will arrive at Puri at 09.05p.m.

This train will stop at Pundi, Rauthpuram, Naupada, Tekkali, Pedasana, Temburu, Ganguvada, and Pathapatnam between Palasa and Paralakhemundi. The timings of 217/218 Puri-Paralakhemundi-Puri passenger will remain unchanged between Puri & Palasa. The train will run as a special train on the flagging off day of the extended portion and the regular run will be from Puri w.e.f 19th December and from Paralakhemundi w.e.f 20th Dec’2010.

8447 Bhubaneswar-Koraput Hirakhand Express, which is leaving Bhubaneswar at 07.35p.m and arriving Koraput at 09.45a.m on the next day, will leave Koraput at 10.05a.m and will arrive at Jagadalpur at 12.40p.m in the extended portion. In the return direction, 8448 Jagadalpur-Bhubaneswar Hirakhand Express will leave Jagadalpur at 03.30p.m and will arrive at Bhubaneswar at 08.25a.m on the next day.

This train will stop at Jeypore and Jagadalpur in the extended portion. The timings of 8447/8448 Bhubaneswar-Jagadalpur-Bhubaneswar Hirakhand Express will remain unchanged between Bhubaneswar and Koraput. The train will run as a special train on the day of flagging off of the extended portion and the regular run will be from Bhubaneswar on 18th December and from Jagadalpur from 19th Dec’2010.

Sambalpur-Howrah via Angul weekly express to commence from Dec 11th 2010

KGP...Lakshannath Rd - Bhadrakh, Railway Budget 2010, Rajathagara - Nergundi, Sambalpur - Talcher, Time table and websites 4 Comments »

Following is an excerpt from http://orissadiary.com/CurrentNews.asp?id=22808.

As announced in the last Railway Budget, Ministry of Railways has decided to introduce three new trains in East Coast Railway jurisdiction. Puri-Howrah-Puri daily Duronto Express will be introduced from 7th December 2010; Sambalpur-Howrah-Sambalpur weekly Express from 10th December & Puri-Digha-Puri weekly express will be introduced from 11th December 2010.

2278 Puri-Horah Duronto Super Fast Express will leave Puri at 06.45a.m and will arrive at Howrah at 01.45p.m. In the return direction, 2277 Howrah-Puri Duronto Super Fast Express will leave Howrah at 02.25p.m and will arrive at Puri at 09.40p.m. This train has One AC Chair Car, 11 Second Class Chair Car and Two Guard vans having no intermediate stoppage.

2586 Sambalpur-Howrah weekly Super Fast express via Angul & Bhadrak will leave Sambalpur at 07.55p.m. on Fridays and will arrive at Howrah at 07.05a.m. on the next days. Similarly, in the return direction, 2585 Howrah-Sambalpur weekly Super Fast express via Bhadrak and Angul will leave Howrah at 08.55p.m on Saturdays and will arrive at Sambalpur at 08.10a.m. on the following days. This train has One AC-2 tier, One AC-3 tier, Six Sleeper Classes, Six General Second Class Coaches and Two Guard cum Luggage vans in its composition having stoppages at Rairakhol, Boinda, Angul, Talcher Road, Dhenkanal, Jajpur Keonjhar Road, Bhadrak, Balasore and Kharagpur between Sambalpur and Howrah.

2580 Puri-Digha weekly Super Fast express will leave Puri at 11.35p.m on Saturdays and will arrive at Digha at 09.30a.m on the next days. In the return direction, 2579 Digha Puri weekly Super Fast express will leave Digha at 05.15p.m. on Sundays and will arrive Puri at 03.20a.m. on the following days. This train has One AC-2 tier, One AC-3 tier, Eight Sleeper Classes, Six General Second Class Coaches and Two Guard cum Luggage vans in its composition having stoppages at Bhubaneswar, Cuttack, Jajpur Keonjhar Road, Bhadrak, Balasore, Kharagpur, Panskura, Tamluk and Kanthi between Puri & Digha. But presently this train will have One AC-2 tier, One AC-3 tier, Five Sleeper Classes, Three General Second Class Coaches and Two Guard cum Luggage vans in its composition.

I am expecting the Sambalpur-Howrah via Angul weekly express to be made daily in the coming years as it newly connects Sambalpur, Angul,Talcher and Dhenkanal to Jajpur Keonjhar Road, Bhadrak, Balasore and Kharagpur and Angul,Talcher and Dhenkanal to Howrah.

Khurda-Balangir line: State pushes to get approval for kms 36-112 (From Samaja)

Khurda Rd - Balangir (under constr.), Odisha govt. action, Railway network in Odisha 3 Comments »

ECOR to make an indoor stadium in Bhubaneswar: Samaja

Bhubaneswar- Cuttack- Puri, ECOR, Khordha, Odisha sports Comments Off on ECOR to make an indoor stadium in Bhubaneswar: Samaja

The positives of BPUT operations happening in Rourkela

Bhubaneswar- Cuttack- Puri, Khordha, Rourkela, Rourkela- Kansbahal, Sundergarh, Talcher - Bimlagarh (under constr.) 3 Comments »

With more and more BPUT operations moving to Rourkela (thanks to http://rourkelacity.com for the pointer) there could be some huge positives, but not one that people normally think as BPUT’s academic programs in Rourkela will not be better than the programs at NIT Rourkela. But there would be definitely more seats; so that would be good. But the biggest positives would be with respect to connectivity.

In particular, the connectivity between Rourkela and the rest of Odisha, especially the Bhubaneswar area, would improve. Currently not enough attention is being paid to that.

For example, the Talcher-Bimlagarh line will significantly shorten the distance between Bhubaneswar and Rourkela. The distance between them will become 308 kms: BBS-Talcher (114) + Talcher-Bimlagarh(154) + Bimlagarh-Rourkela(40). Currently the shortest distance is 419 kms. Once Talcher-Bimlagarh line is completed one could travel between BBS and ROU in about 5 hours. That would mean one could take a train from one place at 6 and reach the other at 11. Currently the BBS-ROU intercity takes 7hrs 30 minutes one way and 7hs 55 minutes the other way. On the other hand the BBS-SBP takes between 4:40 to 4:50 minutes in the two intercities (BBS-BLGR and SBP-Puri).

So lets hope that the inconvenience caused by having many BPUT operations from Rourkela will lead to people demanding speeding up of the completion of the Talcher-Bimlagarh line and perhaps even the start of shuttle flights between Bhubaneswar and Rourkela.

Another positive would be that more private colleges (not now but in few years when the demand picks up again) may come up close to Rourkela and the frequent travel by college heads to Rourkela could give them ideas to develop the travel corridor in many ways.

So although the convenience argument is often used by many (including me) to support some BPUT operations in Bhubaneswar, where most of the BPUT colleges are, perhaps for the greater and longer term good some inconvenience in the short term can be accepted.

Bringing Rourkela and Bhubaneswar closer (in travel time as well as in people’s mind) would be a big plus for Odisha.

Lets work on operationalizing Talcher-Bimlagarh line in 3-5 years!

Update on Khurda-Balangir and Haridaspur-Paradip; Railway board urged to make additional ex-gratia payment to land losers (From Samaja)

Balangir, Bouda, Haridaspur - Paradeep (under constr.), Jagatsinghpur, Jajpur, Khordha, Khurda Rd - Balangir (under constr.), Nayagarha Comments Off on Update on Khurda-Balangir and Haridaspur-Paradip; Railway board urged to make additional ex-gratia payment to land losers (From Samaja)

Rajsunakhala people unhappy that its station in the Khurda Balangir line has been eliminated: Pragativadi

Khurda Rd - Balangir (under constr.), Nayagarha Comments Off on Rajsunakhala people unhappy that its station in the Khurda Balangir line has been eliminated: Pragativadi

(Thanks to Saumya Mohapatra for the pointer.)

However the 2010 map at http://203.176.113.182/ECOR/website/home.jsp still shows Rajsunakhala station as part of the Khurda-Balangir line.The article below also mentions that land acquisition is over in most places.

Mamata assures that the first phase of Khurda Rd-Balangir rail will be finished in March 2011: Dharitri

Balangir, Bouda, Khordha, Khurda Rd - Balangir (under constr.), Odisha MPs, Railway network in Odisha 4 Comments »
